PROJECT CONSTRUCTION

The Construction Overview section of the website will be finalised once a contractor for the main construction works has been engaged.

Details can be found in the Current Work Status and Maps, Plans and Design tabs shown. Information about these works can also be found in the Project Updates section of the website.

Construction Overview

This section will be populated once a contractor for main construction has been engaged and specific information is available. It will include information about things like:

  1. Main work elements
  2. Locations of site facilities (maps & plans)
  3. Basic program methodology – work zones, program timing etc
  4. Traffic access arrangements for residents
  5. Arrangements to provide residents with access for medical, school, work, emergencies, deliveries to properties etc

There will also be links to relevant information elsewhere on the web site as well as documents which can be downloaded.

Current Work Status

Fixing Country Roads & Fixing Local Roads Improvement Works

The Kempsey-Armidale Road Restoration Project was funded to carry out repair of the road following a series of disasters caused by fire and heavy rains since 2019. The project consists of a number of distinct programs:


  • Emergency works soon after the natural disasters
  • Reconstruction works to rebuild damaged sections of the road
  • Improvement works at specific locations under the Fixing Country Roads and Fixing Local Roads programs
  • Main construction works to rebuild the remainder of the road to pre-disaster condition.


The program of improvement works has been carried out at Flying Fox Cutting, Blackbird Flat and at Big Hill. The works were completed at the end of 2024.


Benefits of the Improvement Works Program

The overall expected benefits of the program include:

  • Improved and safer local access through restoration of road formation width and rehabilitation of road pavement
  • Reduced environmental impacts through restoration of drainage infrastructure and minimisation of future erosion
  • Reduced future maintenance costs.

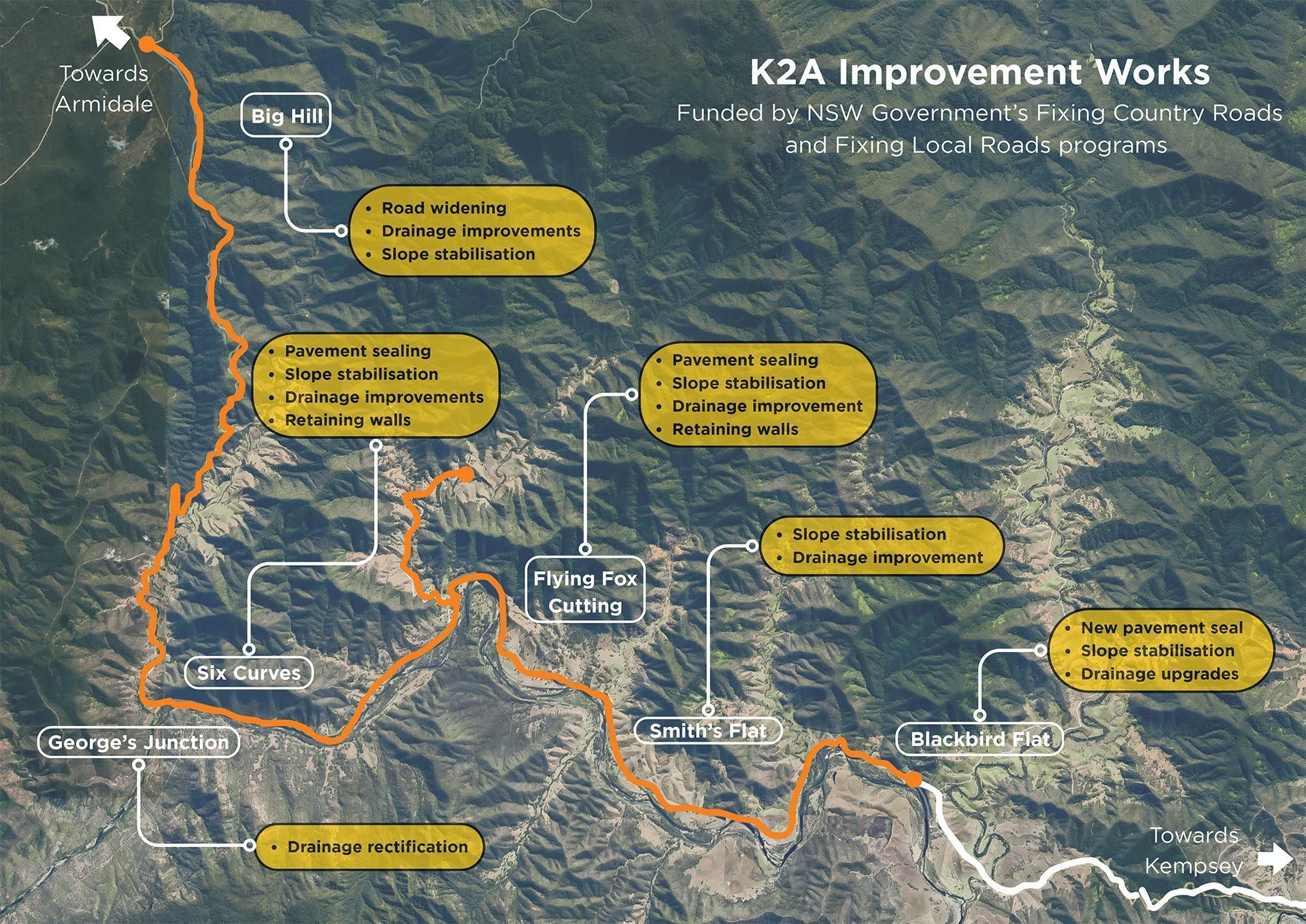

Works being carried out:

BLACKBIRD FLAT

  • Providing improved drainage including dish drains, culverts and outlet scour protection to manage stormwater and minimise future erosion
  • Reinstating the road width on approach to Blackbird Creek bridge
  • Rehabilitating and reshaping the road to provide cross-fall to dish drains
  • Spray sealing a section of the road.

FLYING FOX CUTTING

  • Providing improved drainage including dish drains, culverts and outlet scour protection to manage stormwater and minimise future erosion
  • Reshaping road width and crossfall for a section of the road
  • Completing pavement improvements and seal a section of the road.

BIG HILL

  • Providing improved drainage including dish drains, culverts and outlet scour protection to manage stormwater to minimise future erosion at three locations.


OTHER RELEVANT INFORMATION

  1. Weekly updates have been provided and can be found in the COMMUNITY INFORMATION section of the website under PROJECT UPDATES.
  2. A map showing all Works Completed since February 2022 can be downloaded in the next section below.
  3. A Project Roadmap can be downloaded in the section below. It sets out the significant milestones or steps for the project delivery as well as a summary of works already undertaken and other factors influencing the project.


Maps, Plans & Design

K2A_2D-map

K2A Project map 2D

K2A_3D-Map_v3

K2A_3D-Map_v3 (PDF 1.0 MB)

K2A_2D-Map Works Complete June 2024

K2A_2D-Map Works Complete June 2024_v2 (PDF 1.4 MB)

K2A 2D-Map Works Complete December 2024

K2A Map_Works Completed December 2024 (PDF 605 kb)

Project Development


Interactive Timeline

(Click on the timeline date to review the activity)

  1. Q2 2020

    • Initial Disaster Response begins

  2. Q4 2022

    • Initial Disaster Response ends

  3. Q1 2023

    • Early Contractor Involvement begins

  4. Q3 2023

    • Review of Environmental Factors begins
    • Early Contractor Involvement

  5. Q4 2023

    • Pre-Delivery Phase begins
    • Review of Environmental Factors
    • Early Contractor Involvement

  6. Q1 2024

    • Pre-Delivery Phase
    • Review of Environmental Factors
    • Early Contractor Involvement ends

  7. Q2 2024

    • Independent Project Status Review
    • Pre-Delivery Phase
    • Review of Environmental Factors

  8. Q3 2024

    • Improvement Works (FCR/FLR Programs)
    begin
    • Pre-Delivery Phase
    • Review of Environmental Factors

  9. Q4 2024

    • Improvement Works (FCR/FLR Programs)
    completed
    • Pre-Delivery Phase
    • Review of Environmental Factors finalised

  10. Q1 2025

    • Secure Funding
    • Pre-Delivery Phase

  11. Q2 2025

    • Pre-Delivery Phase
    • Release of Expression of Interest (EOI)

  12. Q3 2025

    • Pre-Delivery Phase
    • Release of Request For Tender (RFT)

  13. Q4 2025

    • Pre-Delivery Phase
    • Evaluation of RFT

  14. First half 2026

    • Award of Main Construction Contract

  15. Second half 2026

    • Detailed Design

  16. Q3 2026

    • Pre-mobilsation of batch plant and site
    camp
    • Main Construction Works

  17. Q4 2029

    • Works finalisation

  18. Q1 2030

    • Project close out

Project Development Documents

K2A Project Roadmap
